Lincoln Common Construction Progress Update - December 15, 2017

Happy Holidays from the Lincoln Common Project Team!

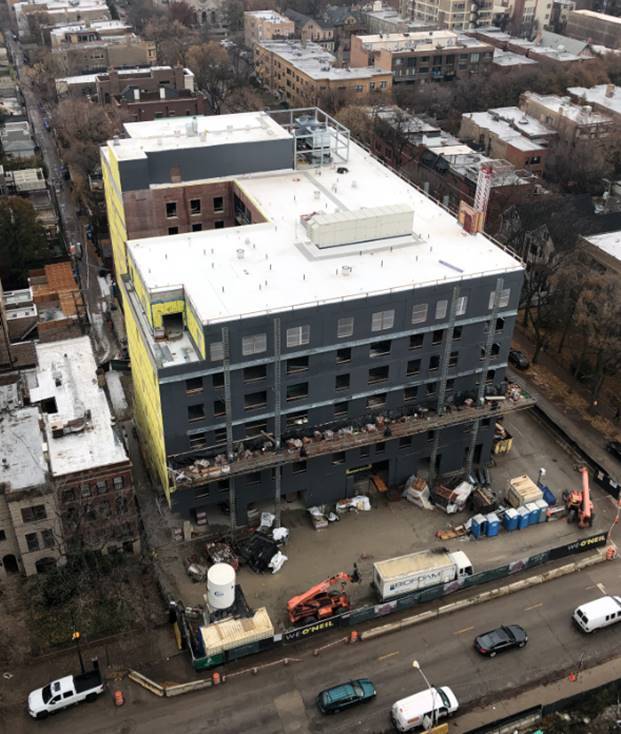

Lincoln Common - View 4-December 14th, 2017, 318 pm.jpg#asset:881

Week of 12/18/17

  • Excavation work will continue on site
  • Concrete work on the A2 South Tower will continue – 2nd floor deck will be poured and 3rd floor decking will start
  • Concrete work on the A1 North Tower will continue – Decking for the 1st floor will continue. Sections of the loading dock basement slab will be poured.
  • D Building work North of the garage – Caisson foundation work will be complete. Sewer work in Lincoln Avenue will start.

Week of 12/25/17

  • Excavation work will continue on site
  • Concrete work on the A2 South Tower will continue –3rd floor deck will be poured
  • Concrete work on the A1 North Tower will continue –1st floor deck will be poured. More of the loading dock basement slab will be poured.
  • D Building work North of the garage – Sewer work on Lincoln Avenue will start. Partial lane closure may occur.
  • Installation of the storm water detention tank under the building footprint will start.

Week of 1/1/18

  • Work to prepare building A2 for water service will begin on Tuesday, 1/2/18 and continue through Wednesday, 1/10/18. During this time, one lane of traffic on Orchard Street will be closed from Kemper Avenue to Lincoln Avenue. The construction area will be barricaded during work hours (9:00 am to 4:00 pm) and all excavation will be plated and pinned at the end of each work day. No parking signs will be posted on Orchard Street from Kemper Avenue to Lincoln Avenue through the duration of work. Please refer to the Site Utility Plan for location details.

We appreciate your continued patience and understanding as The Lincoln Common comes to life! Please visit LincolnCommon.com for additional project details and future updates. More

Lincoln Common Construction Progress Update - December 8, 2017

Happy Holidays from the Lincoln Common Development Team!

D-building-Demo-in-front-of-the-Garage-12.5.17.jpg#asset:821

Week of 12/11/17

  • Excavation work will continue on site
  • Concrete work on the A2 South Tower will continue – Decking for the 2nd floor will continue
  • Concrete work on the A1 North Tower will continue – Decking for the 1st floor will start
  • D Building work North of the garage – Caisson foundation work will start. We will be removing the trees, plantings and planters from in front of the North parking garage entrance to accommodate the caisson drill rig. (See map above.)

Week of 12/18/17

  • Excavation work will continue on site
  • Concrete work on the A2 South Tower will continue – 2nd floor deck will be poured and 3rd floor decking will start
  • Concrete work on the A1 North Tower will continue – Decking for the 1st floor will continue. Sections of the loading dock basement slab will be poured.
  • D Building work North of the garage – Caisson foundation work will be complete. Sewer work in Lincoln Avenue will start.

Week of 12/25/17

  • Excavation work will continue on site
  • Concrete work on the A2 South Tower will continue –3rd floor deck will be poured
  • Concrete work on the A1 North Tower will continue –1st floor deck will be poured. More of the loading dock basement slab will be poured.
  • D Building work North of the garage – Sewer work on Lincoln Avenue will start. Partial lane closure may occur.
  • Installation of the storm water detention tank under the building footprint will start.

We appreciate your continued patience and understanding as The Lincoln Common comes to life! Please visit LincolnCommon.com for additional project details and future updates. More
